·Installed electrical duct bank from main feeder to RTO
Buildings:
·Continued installing wall sheets and trim-out on Building 1 ·Continued installing wall sheets on east side of Building 3 ·Continued installing trim material around louvers on Building 3 ·Completed trim-out on roof framing for wall sheets on Building 6 ·Installed upper wall sheets and translucent panels on Buildings 7, 8, & 11 ·Continued work on mezzanine deck (installed concrete anchors) in Building 8 ·Continued punchlists on Buildings 4, 6, 6A, 7, 8, & 11 ·Installed interior wall sheets between Buildings 9 & 10
Fire Protection:
·Continued installing hose station piping ·Continued installing drum-drips and drains for sprinkler systems ·Continued installing sprinkler systems in Buildings 7, 8, and 11 ·Placed concrete foundation for fire pump building
Electrical:
·Continued electrical rough-in for lighting and miscellaneous electrical services ·Continued installing lighting fixtures in Buildings 2, 4, 5, 9, & 10 ·Continued installing cable tray throughout the plant ·Continued pulling primary electrical feeders to south electrical rooms ·Continued running conduit for process equipment at green-end, dryers, presses, and dry-end ·Completed installing primary underground service to transformers 1-4 on south end of building ·Continued installing underground service to RTO transformer pad; Placed concrete on electrical duct bank to RTO ·Began testing on underground service to transformers and began connections at switchgear and transformers
Racetrack Piping:

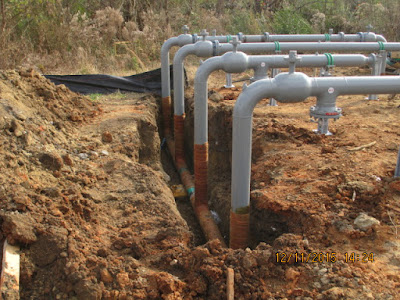

·Completed installing flexible connections between sections of racetrack piping ·Continued installing support hangers for branch lines from racetrack piping ·Completed installation of branch lines for water and air piping from racetrack, and continued insulation on piping
Log Conditioning Vaults

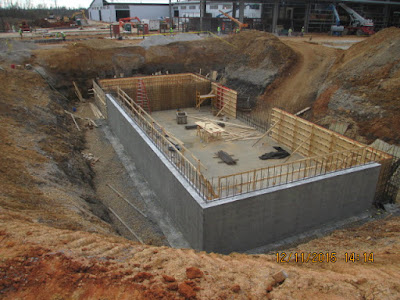

·Continued excavation and placing No. 57 stone for vault foundation ·Continued work on forms for slab on Vaults No. 7-14 ·Set forms, installed reinforcing, and placed Section 1 on Vault Holding Tank walls (North wall, approximately 2/3 of east wall – up to 8’-0”) ·Set forms and installed rebar on west wall & both south walls on Vault Holding Tank
Log Pro Merchandiser:
·Continued setting forms, reinforcing, and embedded steel for foundations ·Placed concrete in Section 1 foundation ·Contractor began setting and welding structural bents on Section 1 foundation
Plant Build-out:

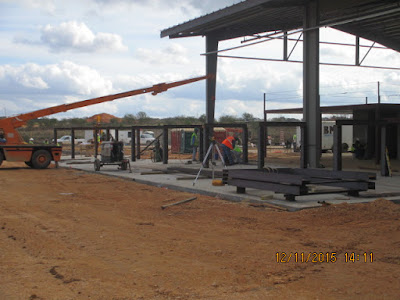

·Performed layout for office area, lunchroom area, and mezzanine area to begin block work ·Masonry contractor mobilized to the site
Winston Plywood:

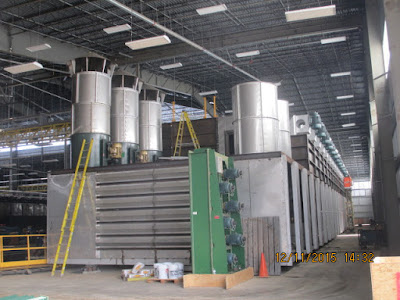

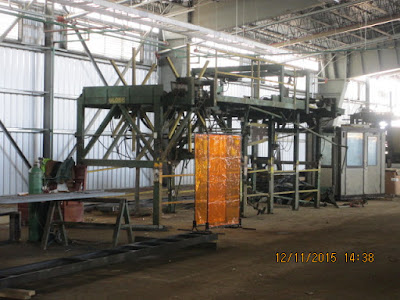

·Continued refurbishing and installing green-end equipment for both east and west lathe lines ·Continued refurbishing Dryer No. 2 ·Continued to receive both new and used process equipment ·Continued construction of No. 3 Veneer Dryer ·Continued installing MCC units throughout plant ·Began installing equipment in Hog Room
Miscellaneous:
·City of Louisville (MDR) completed installing primary power from railroad crossing to corner of parking lot ·Recorded no rain at the site this week ·Contractor continued installing natural gas line to metering station from rail spur ·Continued installing metering station for natural gas piping
