Foundations:

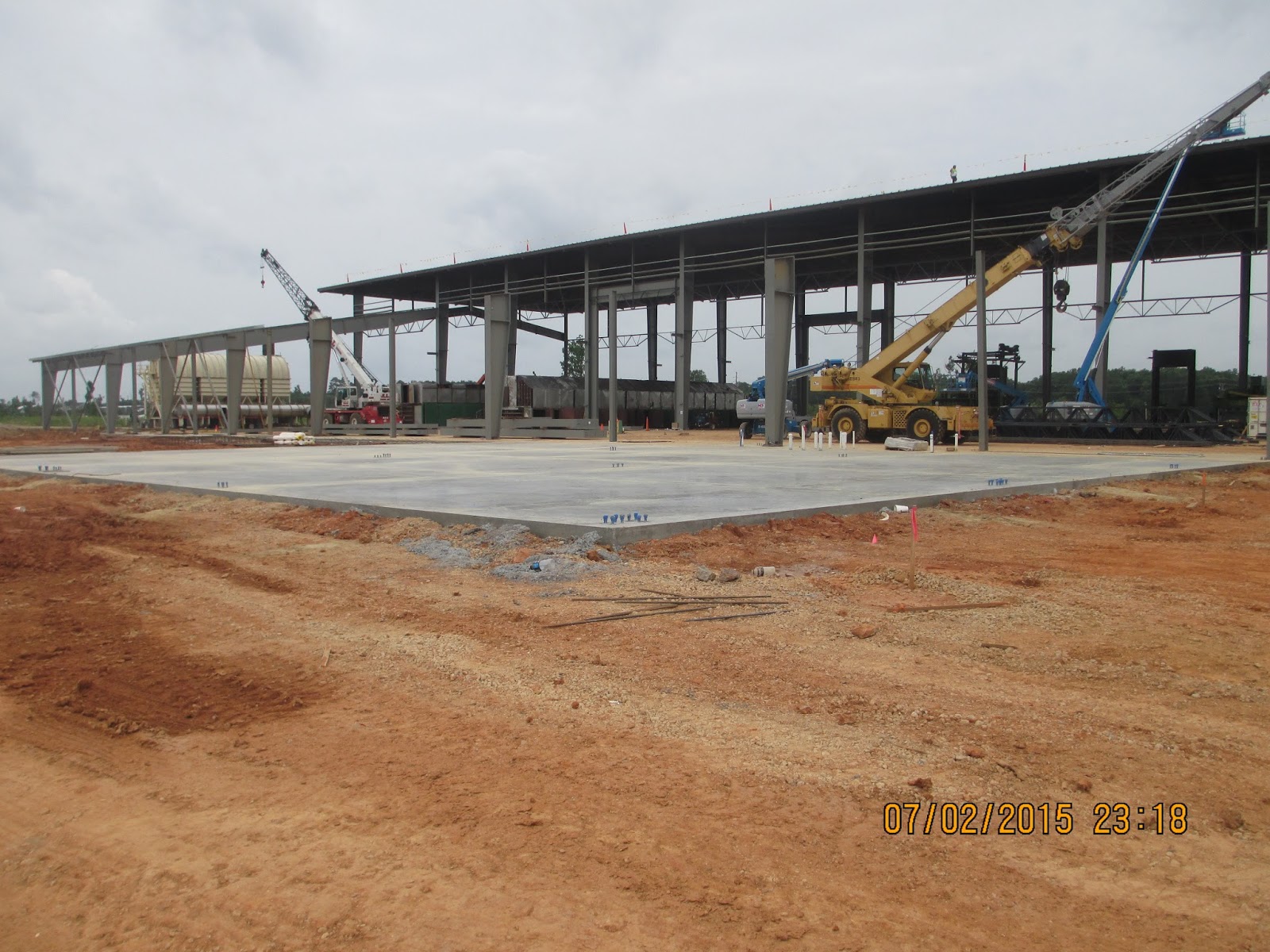

· Formed, placed, and finished foundation/slab for Building No. 8
· Placed grade wall footing on Column Line-A at old access ramp to building (At columns 23-25)
· Completed and backfilled pile caps on Column Line-A
Building:
· Erected exterior columns in Building 3 entire length of building on Column Row P; X-bracing and top girts installed
· Placed rafters on Building 3 at Column Rows 3-5 and installed bar joists in these bays
· Continued installation of insulation, water shield, and standing-seam roofing on Building 1
Electrical:
· Contractor for 13 KV primary power supply continued underground duct banks to transformers and switchboards on south east side of building
Automatic sprinkler protection contractor is to mobilize on Monday, July 6th, and begin installing sprinklers in buildings 1, 9, and 10.
A few photos are attached from this week’s activities on site. Call with any questions you may have regarding items above.
I hope everyone has a safe July 4th holiday weekend as we celebrate this special day in our nation’s history.
